What Is a Contingency Plan? 7-Step Guide to Business Resilience
Table of Contents
Every organisation faces events that cannot be fully predicted. A power failure, a supplier collapse, a cyberattack, or the sudden loss of a key team member can bring operations to a halt within hours. A well-built contingency plan is what separates a business that recovers quickly from one that does not.
This guide explains what a contingency plan is, how it differs from risk management and business continuity planning, and the practical seven-step process for building one that works in a real crisis. It draws on UK professional standards, including ISO 22301, and the business planning principles that help organisations make better decisions under pressure.
ProfileTree, a Belfast-based web design and digital marketing agency, works with SMEs across Northern Ireland, Ireland, and the UK on digital resilience. A core part of that work is helping clients understand that operational preparedness and digital infrastructure go hand in hand.
What Is a Contingency Plan?
A contingency plan is a documented set of procedures, assigned responsibilities, and pre-approved resources that an organisation activates when a specific disruptive event occurs. It is sometimes called a Plan B, but that framing understates its scope. A proper contingency plan identifies the exact conditions that trigger it, outlines step-by-step responses, and assigns named individuals to carry them out.
The core purpose is speed: reducing the time between disruption and restoration of normal operations. Without a plan, teams improvise under pressure. With one, they follow a tested sequence validated in calmer conditions. A contingency plan typically covers risk identification, scenario-specific response procedures, communication protocols, resource and backup arrangements, roles and responsibilities, and a review cycle.
What a Contingency Plan Is Not
Contingency planning, disaster recovery, and risk management are often used interchangeably. They are distinct. A risk management framework is preventive: it reduces the likelihood of risks before they materialise. A contingency plan is reactive: it activates when a defined event occurs. A disaster recovery plan is narrower still, focused on restoring IT systems after a severe incident.
A business that conflates risk management with contingency planning may have a thorough risk register but no tested response procedures for when something goes wrong anyway.
Why Contingency Planning Matters for UK Organisations
Operational disruptions carry direct costs: lost revenue, recovery expenditure, regulatory penalties, and reputational damage. For UK businesses, the regulatory environment adds further pressure. Data breaches carry notification obligations under UK GDPR. Financial services firms face FCA operational resilience requirements. Healthcare organisations have sector-specific continuity duties.
Protecting Reputation and Stakeholder Confidence
Without a contingency plan, the response to a crisis is disorganised, and communications are delayed. With one, the first hour is spent executing pre-agreed steps rather than debating who does what. This matters particularly given the scale of cybercrime affecting UK businesses in recent years.
Businesses that handle disruptions competently tend to emerge with client relationships intact. Those who appear unprepared often lose accounts permanently. The reputation cost of a poorly managed incident typically exceeds the direct operational cost.
Legal and Governance Obligations
UK company directors have a duty of care under the Companies Act 2006 to protect the organisation from foreseeable harm. For regulated industries, documented contingency procedures are a compliance requirement. Businesses handling personal data must have breach response procedures under UK GDPR, with a 72-hour reporting window to the ICO for breaches likely to risk individuals’ rights and freedoms.
The international standard ISO 22301 provides the most widely recognised framework for business continuity management, which encompasses contingency planning. Aligning with its principles gives organisations a credible, auditable basis for their planning even without formal certification.
Contingency Planning vs Risk Management vs Business Continuity
Understanding where contingency planning fits within the broader resilience landscape helps organisations allocate effort appropriately. The three disciplines are complementary, not interchangeable.
| Risk Management | Contingency Planning | Reduces the likelihood of disruption | |
|---|---|---|---|
| Focus | Prevents risks before they occur | Activates when a specific event occurs | Restores full operations after disruption |
| Type | Strategic, ongoing process | Tactical, scenario-specific | Operational, recovery-focused |
| Goal | Reduces likelihood of disruption | Minimises impact when disruption happens | Restores normal service as quickly as possible |
| Standard | ISO 31000 | ISO 22301 aligned | ISO 22301 |
Most organisations benefit from all three layers: a risk management approach that prevents disruptions, contingency plans that activate when prevention fails, and business continuity arrangements that sustain operations through a major event. The guide to crisis management and AI-assisted business continuity explores how digital tools are changing how organisations prepare.

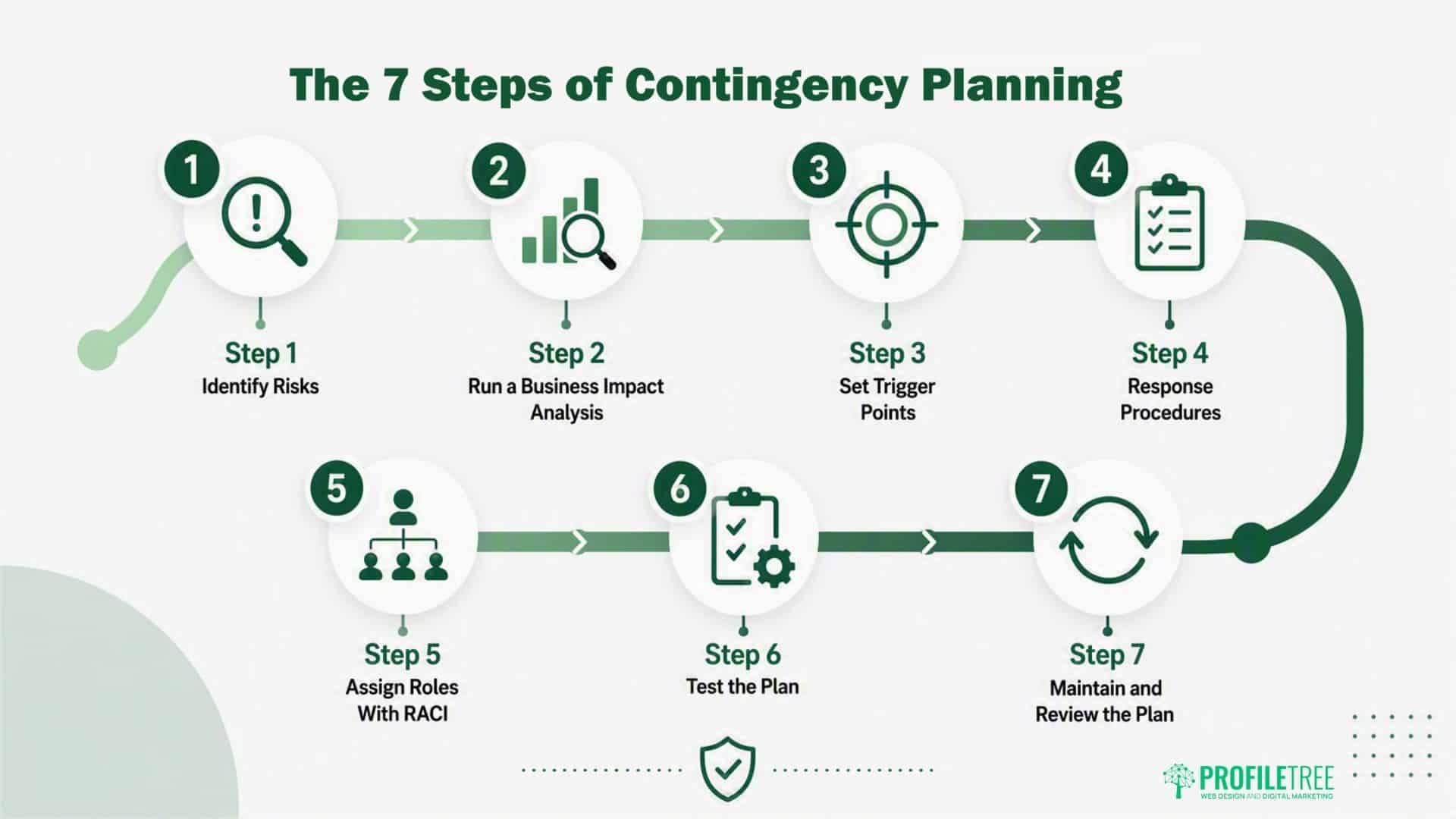

The 7 Steps of a Contingency Plan: A Practical Framework
The following process is aligned with ISO 22301 and adapted for practical use by UK SMEs and mid-sized organisations. Each step builds on the last; shortcutting early stages creates gaps that only become visible during an actual incident.
Step 1: Identify and Prioritise High-Impact Risks
List every plausible disruption that could affect your organisation: cybersecurity incidents, supply chain failures, loss of critical personnel, extreme weather, utility outages, premises access issues, and financial shocks. Then assess each risk against two dimensions: likelihood and impact. A 5×5 risk matrix is a practical tool for this.
| Likelihood / Impact | Minor | Moderate | Major | Critical |
|---|---|---|---|---|
| Almost Certain | MEDIUM | HIGH | CRITICAL | CRITICAL |
| Likely | LOW | MEDIUM | HIGH | CRITICAL |
| Possible | LOW | MEDIUM | MEDIUM | HIGH |
| Unlikely | LOW | LOW | MEDIUM | MEDIUM |
Focus first on high and critical risks. Prioritising by impact and likelihood ensures effort goes where it matters most. The role of data in business decisions article sets out how evidence-based approaches improve strategic outcomes, including risk prioritisation.
Step 2: Conduct a Business Impact Analysis
A Business Impact Analysis (BIA) quantifies what would happen if each high-priority risk materialised. For each scenario, define the Maximum Tolerable Period of Disruption (MTPD): the longest time an organisation can operate without a specific function before damage becomes unrecoverable.
For digital operations, two specific metrics apply. The Recovery Time Objective (RTO) is the target time to restore a system after failure. The Recovery Point Objective (RPO) defines how much data loss is acceptable. An organisation might set an RTO of four hours for its CRM system and an RPO of two hours, meaning no more than two hours of transaction data can be lost.
Step 3: Define Trigger Points and Activation Criteria
Most contingency plans fail not because response procedures are wrong, but because no one was certain when to activate them. Trigger points must be concrete, not vague. “If the primary data centre is inaccessible for more than two hours” is a trigger. “If there is a significant IT issue” is not.
Define a named incident commander with authority to declare the plan activated. Document escalation thresholds and, for regulated firms, the conditions under which the FCA, ICO, or another body must be notified.
Step 4: Develop Response Strategies and Recovery Procedures
Write the actual response procedures for each high-priority scenario specific enough that a team member unfamiliar with the plan could follow it under pressure. Document the sequence of actions within the first one, four, and twenty-four hours; alternative systems or suppliers to use; required regulatory notifications and timescales; and any client communications that must go out.
Where digital infrastructure is involved, backup arrangements must be pre-contracted, not aspirational. A procedure that says “arrange temporary cloud hosting if the server fails” is a wishlist, not a plan.
Step 5: Assign Roles and Responsibilities Using RACI
Every action in a contingency plan must have a named owner. The RACI matrix assigns each action to who is Responsible (does the work), Accountable (owns the outcome), Consulted (provides input), and Informed (kept updated). Without this clarity, critical steps are duplicated or missed entirely.
Assign deputies for every key role and document out-of-hours contact details for all named individuals. Review them at least quarterly. Effective project management and team coordination practices significantly improve plan execution under pressure.
Step 6: Test, Train, and Exercise the Plan
A contingency plan that has never been tested is an educated guess. Tabletop exercises cost an afternoon. An untested plan during a real incident can cost you clients, data, and months of recovery.
Testing Methods
- Tabletop exercise: A facilitated discussion working through a hypothetical scenario. Low cost, high value for initial testing and onboarding new team members.
- Walkthrough drill: Team members perform their assigned actions in a controlled setting. Confirms procedures are practical, not just theoretical.
- Functional simulation: A live-scenario test under time pressure. Observers track response times, communications, and resource use.
- Full-scale drill: The most comprehensive test, involving all departments. Typically run annually for high-risk functions.
Document every test. Record what worked, where delays occurred, and what the plan missed. Update procedures before the next cycle.
Step 7: Maintenance and Continuous Review
A contingency plan is a living document. Review it annually and after any significant change: a new system, a key staff departure, a merger, or a change in supplier relationships. After any real incident or test, update the plan to capture lessons before they are forgotten.
For organisations undergoing digital transformation, the contingency plan must evolve in parallel. As more functions move online, digital security and data protection practices become central to operational resilience rather than peripheral IT concerns.
Contingency Plan Examples for UK Businesses
Three common scenarios illustrate how a contingency plan functions in practice.
Cyberattack or Ransomware Incident
- Trigger: critical systems are encrypted, and a ransom demand has been received.
- Immediate actions: isolate affected systems; notify the incident commander; activate backup data access from a pre-contracted clean environment; notify the ICO if personal data may be compromised.
- Recovery: restore from the most recent verified backup; conduct a post-incident security review.
Sudden Loss of a Key Supplier
- Trigger: primary cloud hosting provider suffers a catastrophic outage with no confirmed restoration timeline beyond four hours.
- Immediate actions: activate the pre-contracted secondary provider; redirect DNS to the backup environment; notify affected clients of a potential temporary service degradation.
Loss of Critical Personnel
- Trigger: the individual managing a critical client account or system becomes suddenly unavailable for more than 48 hours with no handover completed.
- Immediate actions: activate the named deputy from the RACI matrix; brief them using documented procedures; notify the client if appropriate.
Common Pitfalls in Contingency Planning
Most contingency planning failures trace back to the same avoidable mistakes.
Plans That Are Never Tested
A plan written once and never reviewed is a compliance artefact, not a contingency plan. Technology changes, people change, and risks evolve. A plan referencing systems that no longer exist or people who have left is actively misleading in a live incident.
Vague Trigger Points
Vague activation criteria delay response. Specificity in triggers is one of the single most impactful improvements an organisation can make to an existing contingency plan.
No Pre-Approved Budget
Pre-approve spending authorities within the plan: who can commit to what expenditure without board sign-off during a declared incident. For SMEs, financial controls can inadvertently obstruct a rapid response if this is not addressed in advance.
Putting a Contingency Plan Into Practice
A contingency plan earns its value when things go wrong, not when they are going well. The organisations that recover fastest are those that have already made the key decisions: who leads the response, what actions come first, and what resources are pre-approved. That groundwork cannot be laid during a crisis.
For businesses with significant digital operations, a contingency plan must account for the specific vulnerabilities of online infrastructure. ProfileTree’s web design and digital marketing services for Northern Ireland businesses include resilience advisory as part of broader digital strategy work, helping clients build systems that can be recovered as well as maintained.
The seven steps in this guide provide a practical starting point. Build the plan, test it, assign the roles, and review it regularly. A plan that exists only as a document is the beginning of a contingency plan, not the end.
FAQs
1. What are the 7 steps of a contingency plan?
The seven steps are: (1) identify and prioritise high-impact risks; (2) conduct a Business Impact Analysis; (3) define trigger points and activation criteria; (4) develop scenario-specific response and recovery procedures; (5) assign roles and responsibilities using a RACI matrix; (6) test the plan through tabletop exercises and simulations; and (7) review and update the plan on a scheduled basis and after any significant change.
2. What is the most important part of a contingency plan?
Defining clear trigger points is the most overlooked element. A plan with thorough procedures but vague activation criteria will be activated too late. Equally, assigning named deputies for every critical role is essential: a plan that depends on a single individual being available fails in precisely the scenario where that person is unavailable.
3. Is a contingency plan a legal requirement in the UK?
There is no single law requiring all UK businesses to have a contingency plan, but legal obligations arise from sector-specific regulation and governance duties. UK GDPR requires documented breach response procedures. The FCA’s Operational Resilience Policy Statement (PS21/3) requires regulated firms to demonstrate resilience against severe disruption scenarios. Directors also have a duty of care under the Companies Act 2006.
4. How does a contingency plan differ from a disaster recovery plan?
A contingency plan is business-wide: it covers any type of disruptive event including personnel loss, supply chain failure, and regulatory action. A disaster recovery plan is IT-specific: it focuses on restoring technology systems after a severe incident. Disaster recovery is a subset of contingency planning. A well-structured contingency plan should include a disaster recovery component with defined RTO and RPO metrics for each critical system.
5. How often should a contingency plan be updated?
Review annually and after any significant organisational change: a new system, a key staff departure, a change in primary suppliers, or an update to applicable regulation. After any real incident or test exercise, update the plan immediately to capture lessons learned. Organisations undergoing active digital transformation should review their contingency plans more frequently, as the risk profile of a digitally maturing business changes quickly.
